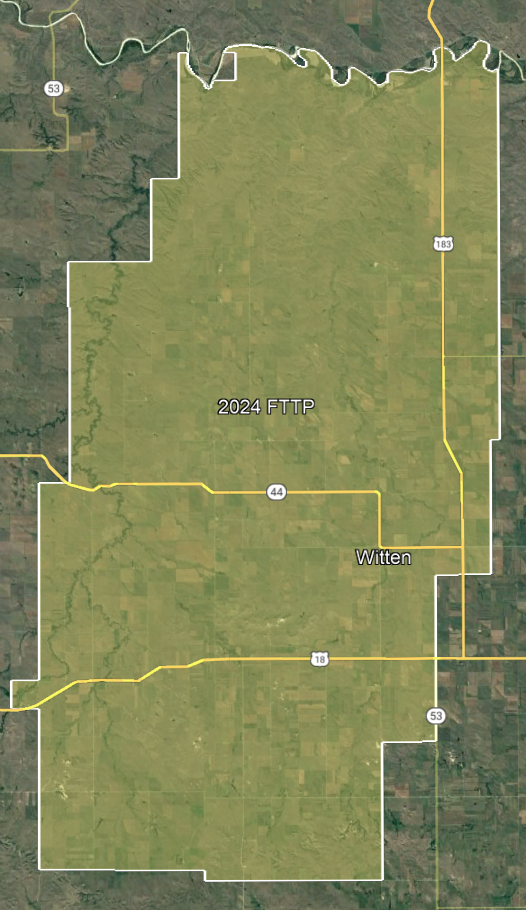

Witten
The remainder of the Witten exchange where all necessary rights of way have been secured will be upgraded to fiber in 2024.
Contractors:
Wiring Contractor – Travis Electric
Engineering Consultant – RVW, Inc.
Construction Contractor – Cable Communications Services
PROJECT UPDATE
January 16, 2025
- The engineering consultant has reviewed and approved the fiber splice test results.
- Golden West technicians will be completing the final wiring in the GW office in Witten next week.
- Customers will be notified by letter before Travis Electric begins scheduling installations.
January 9, 2025
- Fiber splicers have made repairs. RVW is reviewing the splice test results.
- After engineers have reviewed and approved the fiber testing, Golden West will complete the last wiring step in the Witten office.
- Customers will be notified by letter before Travis Electric begins scheduling installations.
January 2, 2025
- Fiber splice test results showed areas that need to be retested and repaired. Splicers will return to the area this week to make repairs.
- Customers will be notified by letter before Travis Electric begins scheduling installations.
December 19, 2024
- Fiber splice test results showed areas that need to be retested and repaired. Splicers will return to the area in early January to make any needed repairs.
- CCS is working on cleanup in the project area this week.
- Customers will be notified by letter before Travis Electric begins scheduling installations.
December 12, 2024
- RVW is reviewing the fiber splice tests and updating maps in preparation for upgrading customers to fiber.
- A crew from CCS will return to finish cleanup when the ground freezes.
- Customers will be notified by letter before Travis Electric begins scheduling installations.
December 5, 2024
- Fiber splicers are working on testing the fiber now that all splicing is complete.
- A crew will return to finish cleanup when the ground freezes.
- Customers will be notified by letter before Travis Electric begins scheduling installations.
